Reducing the time required to complete an activity (in hopes that this will reduce the completion time of the entire project) by assigning additional resources to that activity but reducing the duration time of the activities on the critical path may change the critical path.
Approaches to crashing a project network
1. Minimum-time schedule" method

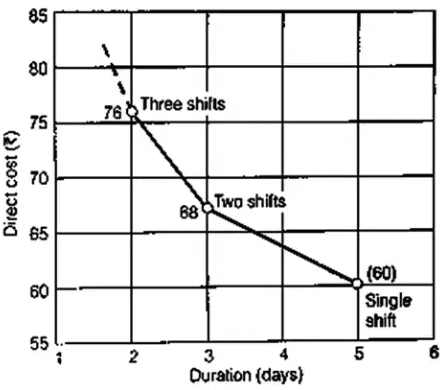

2. "Minimum cost schedule" method

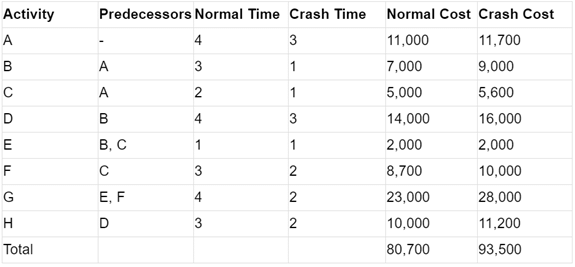

Example
Project Planning with Uncertain Activity Time
Generally, the distribution of the activity times is unknown and must be estimated. A typical method of dealing with the situation is to estimate three activity duration times for each activity, optimistic, most likely and pessimistic. Use these estimates to estimate a normally distributed activity time:
Most optimistic time (a): the probability of completing the activity in less than a is about 1%
Most likely time (m): the estimated average time required to complete the activity.
Most pessimistic time (b): the probability of taking longer than b is about 1%
The activity time is assumed to be normally distributed with mean, te, and variance as follows:
Expected time: te = ( a + 4m + b ) / 6
Variance: var[te] = [ ( b - a) / 6 ]2
Assumptions
Note: Only considering the critical path makes a very strong assumption. In real situations, you should be aware of the other paths which may become critical. If an activity not on the critical path has a large variance of a duration time, that activity can become a critical path activity simply through random occurrences.

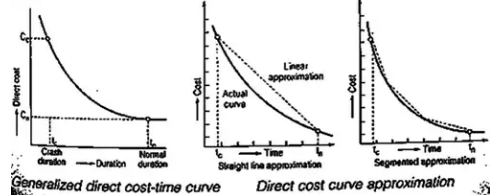

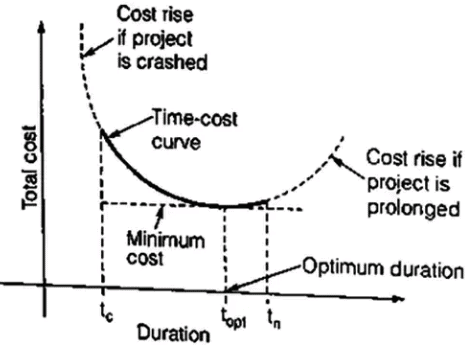

Cost Model Analysis
In the whole of the CPM Cost Model, we will be assuming that project duration is reduced by deploying more resources on critical activities.
1. Project Cost

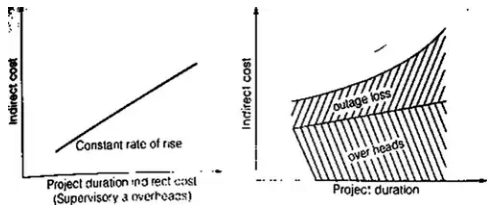

Total Project cost is the sum of two separate costs the direct cost for accomplishing the work, and the indirect cost related to the control or direction of that work, financial overhead, lost production, and the hike.

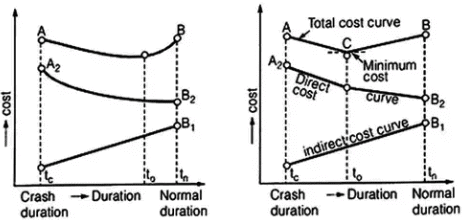

The components of the total cost are depicted in figure
2. Components of Project cost
